Validation is the documented evidence that a cleanroom facility consistently performs according to its intended use and regulatory requirements. In the pharmaceutical and biotech industries, this process is governed by Good Manufacturing Practice (GMP) and ISO 14644 standards. As a validation specialist, I will detail the essential stages of the Validation Life Cycle, from design to performance verification.
1. The Validation Master Plan (VMP)
The VMP is the high-level document that defines the overall validation strategy, scope, and responsibilities. It serves as the roadmap for all qualification activities, ensuring that every critical system—including HVAC, water systems, and compressed gases—is identified and addressed.
2. Qualification Stages (DQ, IQ, OQ, PQ)
The validation process follows a sequential “V-Model” approach, ensuring that each stage is successfully completed before moving to the next.
2.1 Design Qualification (DQ)
DQ verifies that the proposed design of the facility and utilities is suitable for the intended purpose and complies with GMP. This includes reviewing P&IDs, layout drawings, and User Requirement Specifications (URS).
2.2 Installation Qualification (IQ)
IQ confirms that the equipment and systems are installed correctly according to the approved design and manufacturer’s specifications.
- Verification of Materials: Ensuring all surfaces are non-shedding and chemically

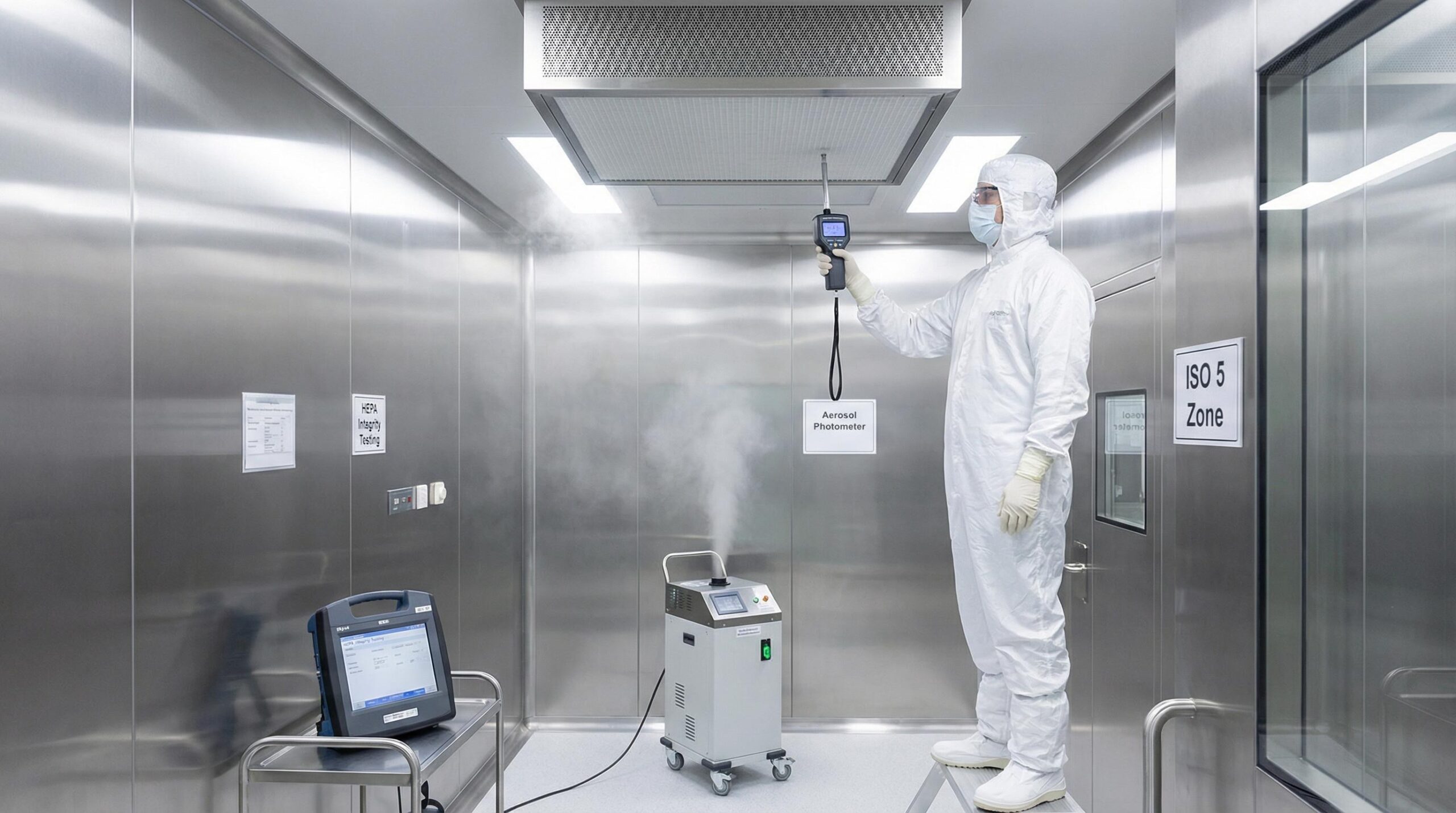

- HEPA Filter Integrity: Performing leak tests to ensure no bypass or media

2.3 Operational Qualification (OQ)
OQ demonstrates that the system operates as intended throughout all anticipated operating ranges.
- Airflow Visualization (Smoke Test): Verifying laminar flow patterns and ensuring no stagnant zones.
- Pressure Control: Testing the system’s ability to maintain differential pressure during door openings.

2.4 Performance Qualification (PQ)
PQ is the final stage, performed under “at-rest” and “in-operation” conditions. It proves that the cleanroom consistently achieves the required cleanliness class while personnel are working and equipment is running.

3. Critical Performance Parameters
To achieve successful validation, the following parameters must be rigorously tested and documented:
| Parameter | Test Method | Standard Reference |
|---|---|---|
| Airborne Particles | Discrete Particle Counter | ISO 14644-1 |
| Airflow Velocity | Anemometer | ISO 14644-3 |
| Differential Pressure | Pressure Transducer | ISO 14644-3 |
| Recovery Time | Particle Challenge Test | ISO 14644-3 |
| Microbial Levels | Settle Plates / Air Samplers | European Commission GMP Annex 1 |
4. Expert Insights for Successful Validation
- Risk-Based Approach: Focus validation efforts on “Critical Process Parameters” (CPPs) that directly impact product quality.
- Documentation Integrity: Ensure all test results are recorded in real-time following ALCOA+ principles (Attributable, Legible, Contemporaneous, Original, Accurate).
- Re-validation Strategy: Establish a clear schedule for periodic re-qualification (typically every 6-12 months) or after significant facility modifications.
- Personnel Training: Validation is only as good as the people performing Ensure all technicians are trained in aseptic techniques and instrument operation.
5. Conclusion
Validation is not a one-time event but a continuous commitment to quality. A robust validation scheme, supported by detailed DQ/IQ/OQ/PQ protocols, provides the foundation for safe and effective pharmaceutical manufacturing. By adhering to international standards and utilizing advanced testing methodologies, facilities can ensure long-term compliance and operational excellence.
